The CDE (Common Data Environment) lists your plans in a table, one row per plan. Each plan is identified by its naming convention: FunBIM reads the name of the imported file, splits it according to the project's naming convention and creates the matching row automatically.

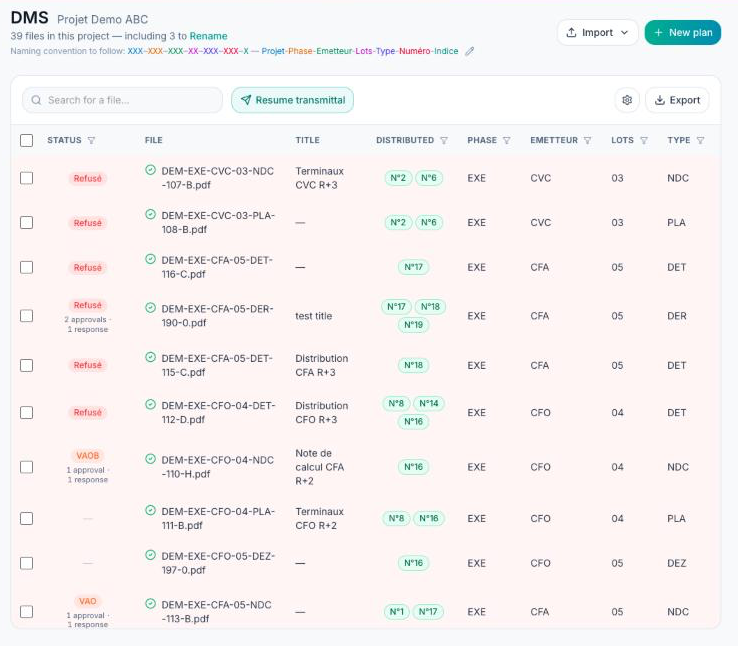

CDE page of a project: naming convention to follow under the title, Import and New plan buttons, table of plans with their status, distribution and naming segments
The CDE page: the naming convention to follow is shown under the title.
1

Open the project, then “GED” in the left-hand menu (the page is titled “CDE”).

2

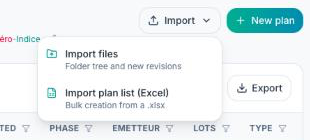

Click “Import”, then “Import files”.

CDE Import menu: Import files, Import plan list (Excel)
The CDE “Import” menu.
3

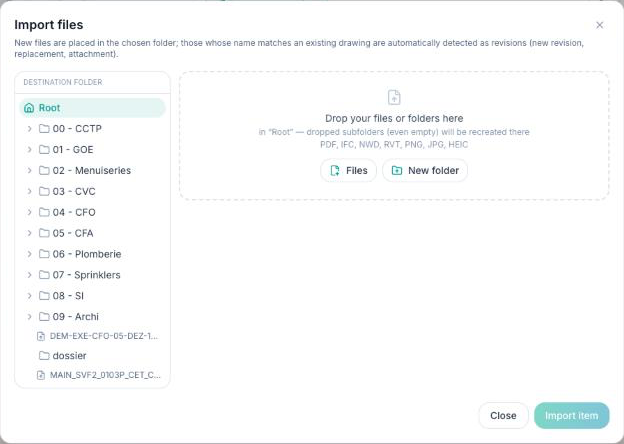

In the “Import files” window, choose the destination folder on the left (“Root” by default, or “New folder” to create one).

4

Drop your files or folders into the area on the right, or click “Files” to pick them from your computer.

5

Check the list, then click “Import”.

Import files window: destination folder tree on the left, drop area on the right
The “Import files” window: destination folder on the left, drop area on the right.

Accepted formats: PDF, DWG, IFC, NWD, RVT, PNG, JPG/JPEG and HEIC. DWG (AutoCAD) plans are now accepted, alongside PDFs. Dropped subfolders are recreated as they are in the chosen folder.

Before the import, each file gets a badge based on its name:

Text placed after the naming code becomes the plan title: “DEM-EXE-MEN-02-PLA-105-A - Ground floor.pdf” gets the title “Ground floor”.

A file whose name does not follow the naming convention is imported, but no plan is created. The “including N to Rename” counter appears under the page title: click “Rename” to fix their names (FunBIM shows live whether the naming is valid) or “Ignore” them.

The “Import” and “New plan” buttons only appear once the project's naming convention is set up (see “How do I set up the CDE?”), and only for members allowed to import files. “New plan” creates a row without a file, by typing the naming code by hand.
